Hutton Street Extension

Hutton Street Extension
  • Open date

    02 October 2024

Last update date: 28 May 2026

The City has completed the detailed design of the Hutton Street extension through to Walters Drive (Stage 1) and is progressing planning and procurement for construction.

Background

On 5 January 2018, Amendment 1291/41 to the Metropolitan Region Scheme was gazetted which reserved land for an extension of Hutton Street from Scarborough Beach Road through to Jon Sanders Drive.

The City undertook an investigation into the feasibility of extending the road in either one stage directly to Jon Sanders Drive, or in two stages being initially to Walters Drive and then finally to Jon Sanders Drive. The Western Australian Planning Commission also acquired the land required for the extension to Walters Drive.

The extension of Hutton Street aims to improve traffic flow in the area by reducing congestion on Scarborough Beach Road and other roads in the immediate network. Hutton Street will play an increasingly important role in the transportation of freight between Osborne Park and the broader region.

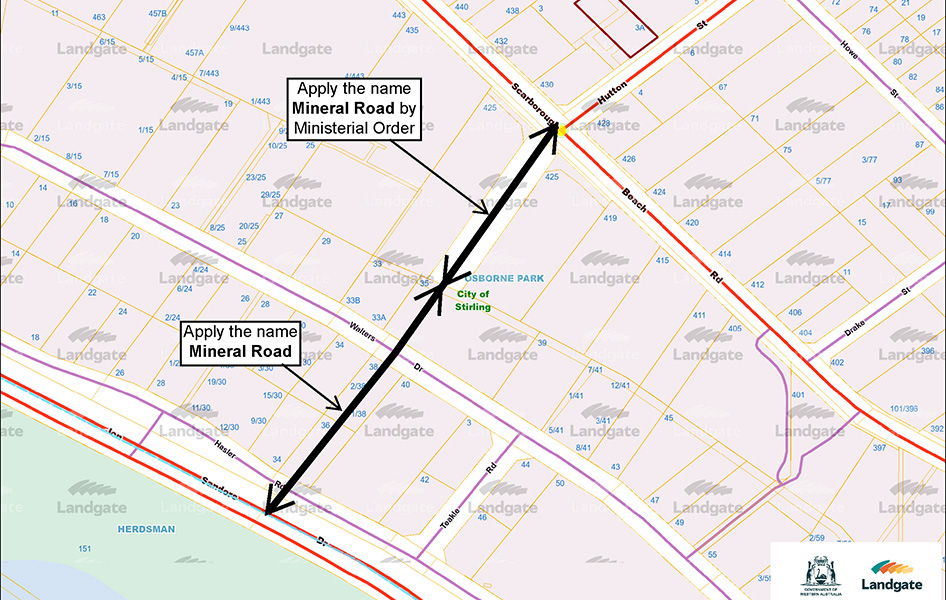

In June 2024, the road south of Scarborough Beach Road was renamed Mineral Road. Please refer to the map below for the extent of Mineral Road.

Project update (May 2026)

The detailed design for Stage 1 has now been completed and was endorsed by Main Roads Western Australia (MRWA) through the Traffic Signal Approval Policy (TSAP) process.

The City is progressing procurement for construction while awaiting the outcome of the funding application through the MRWA’s Metropolitan Regional Road Group (MRRG) process, expected in July 2026.

The timing for construction and opening of the road remains subject to funding contributions from the State Government.

Project timeline

August 2023

Start of concept designs and option selection process

July 2024

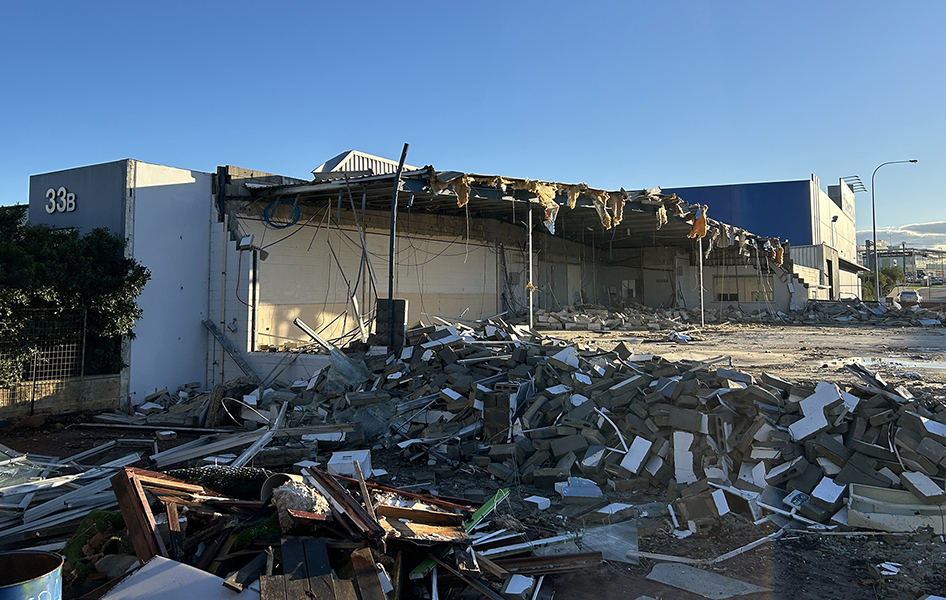

Demolition works completed

August 2024

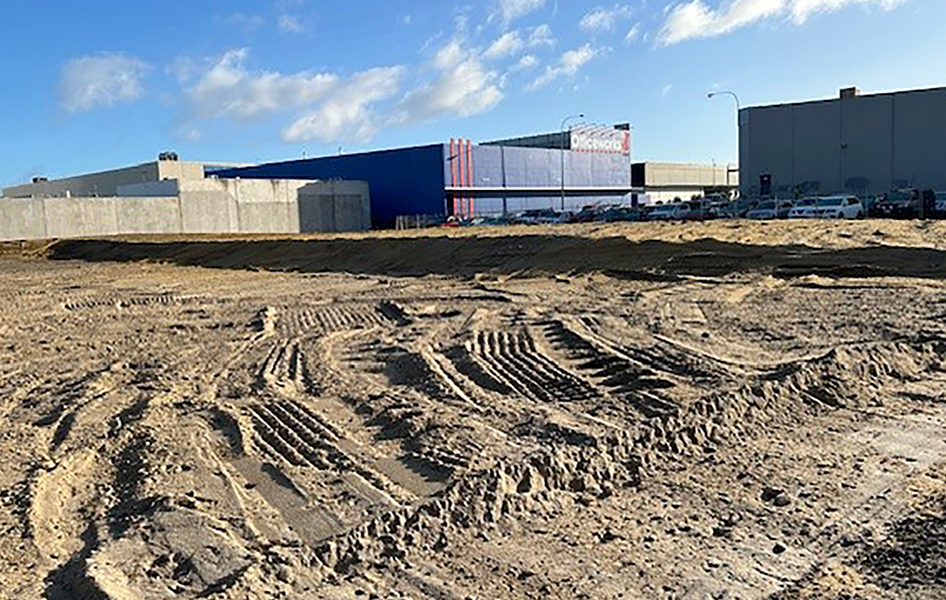

Feature and Utilities Surveys completed

August 2024

Start of detail design for the preferred option

March 2025

15% design endorsed by MRWA

May 2025

85% design accepted by the City and funding application submitted to MRWA

December 2025

100% design complete

July 2026

MRWA’s decision about City’s funding application

2026

Construction procurement (tender process)

2027

Construction starts, subject to successful state funding contributions for the project

2028

Road opens

View more

For more information, or to receive this information in an alternate format, please contact the City on (08) 9205 8555 or visit www.stirling.wa.gov.au/enquiry.
